Sawra Kuddu project will start generation by April

By IANS | Updated: February 20, 2020 19:00 IST

The first unit of 111 MW Sawra Kuddu Hydroelectric Project in Himachal Pradesh's Shimla district will start generating power by April, state-run Himachal Pradesh Power Corporation Ltd (HPPCL) said on Thursday.

Open in App

Shimla, Feb 20 The first unit of 111 MW Sawra Kuddu Hydroelectric Project in Himachal Pradesh's Shimla district will start generating power by April, state-run Himachal Pradesh Power Corporation Ltd (HPPCL) said on Thursday.

The process of filling headrace tunnel will start shortly, HPPCL Director (Civil) D.S. Thakur said.

He said the execution of the project started in June 2007. The main bottleneck in its construction was excavation of 11.365 km headrace tunnel owing to adverse geological rock conditions.

Besides tough rock strata, high ingress of water along with flowing rock conditions at various locations had to be tackled cautiously with high engineering proficiency.

The work of the barrage was awarded to Patel Construction Company and headrace tunnel was initially awarded to Aban Coastal joint venture in June 2007.

Later, the barrage construction was carried out by Hindustan Construction Company Ltd in November 2014.

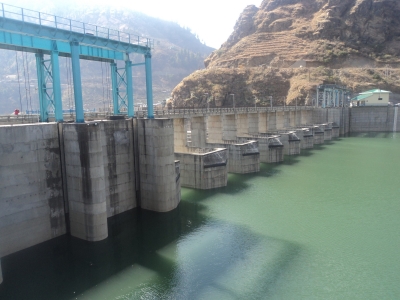

The project comprises a diversion barrage on the Pabbar river near Hatkoti and underground powerhouse on the left bank of the river near Snail village.

The project will generate 386 million units per annum in a 90 per cent dependable year, earning a revenue of Rs 115 crore to the state.

It has 11.365 km long, 5 m finished diameter headrace tunnel and three 37 MW Francis turbines.

After commissioning the project, each project affected family will be provided 100 units of electricity per month free for 10 years. In addition, one per cent of the revenue from power generation will be contributed for the local area development during the operation stage.

HPPCL has already commissioned two hydroelectric projects Sainj Hydroelectric Project (100 MW) and Kashang Hydro Electricproject Stage-1 (65 MW) in September 2017.

It has also commissioned a 5 MW Solar Power Project constructed near the hilltop Naina Devi shrine in Bilaspur district in 2019.

The work of Shongtong Karchham Hydroelectric Project (450 MW) is on.

( With inputs from IANS )

Open in App

Related Stories

InternationalSouth Korea: Water storage rate at drought-hit Gangneung's reservoir rises for 1st time in 52 days

International"Reflection of deep civilizational links...": MEA shares pictures from Mauritius PM's visit to Ram Janmabhoomi Temple

EntertainmentAP Dhillon shares the unusual course of his new track ‘Without Me’

EntertainmentAjay Devgn wishes his ‘strongest critic, softest corner’ Yug on 15th birthday

BusinessIndieVisual Crosses 1,000 Videos for 150 Clients: Redefining Video Production Infrastructure for India's Enterprises

कारोबार Realted Stories

BusinessLogistic and industrial leasing in India poised to cross 60 MSF by year-end: Report

BusinessLynkit Secures Second Patent for Its Proprietary Delivery Assistance System and Method

BusinessREVIVO announces launch of Live Laundromat and Master Franchise opportunities in India's ₹2 lakh crore laundry market

BusinessMohammed Mohsin Wins Outstanding Datawarehouse BI Specialist of the Year at Brand Empower's Industry Leaders Awards 2023

BusinessAfter pan-India success, Maison Gourmestan set to take over Dubai palates with Shivani Sharma’s revolutionary millets-forward mantra
